Enerjisa Üretim
Enerjisa Üretim

2022 Annual Report

2021 Annual Report

2020 Annual Report

Generation

RENEWABLE ENERGY PLANTS

We generate energy with 8 wind, 2 solar and 12 hydroelectric power plants. 46% of our installed power consists of the aforementioned renewable power plants.

Wind Power Plants

AKHİSAR WPP

INSTALLED POWER: 55 MW TURBINE: 22 COMMISSIONING: 2011 MAIN EQUIPMENT: NORDEX LOCATION: MANİSA

ÇANAKKALE WPP

INSTALLED POWER: 30 MW TURBINE: 13 COMMISSIONING: 2011 MAIN EQUIPMENT: SIEMENS LOCATION: ÇANAKKALE

AKKÖY WPP

INSTALLED POWER: 25.2 MW TURBINE: 6 COMMISSIONING: 2023 MAIN EQUIPMENT: ENERCON LOCATION: AYDIN

ÇEŞME WPP

INSTALLED POWER: 18.9 MW TURBINE: 6 COMMISSIONING: 2015 MAIN EQUIPMENT: NORDEX LOCATION: İZMİR

DİKİLİ WPP

INSTALLED POWER: 7.2 MW TURBINE: 2 COMMISSIONING: 2021 MAIN EQUIPMENT:
SENVION TURBINEİ
LOCATION: KOCAELİ

BALIKESİR WPP

INSTALLED POWER: 143 MW TURBINE: 52 COMMISSIONING: 2013 MAIN EQUIPMENT:
GENERAL ELECTRIC
LOCATION: BALIKESİR

DAĞPAZARI WPP

INSTALLED POWER: 39 MW TURBINE: 13 COMMISSIONING: 2012 MAIN EQUIPMENT: SIEMENS LOCATION: MERSİN

ERCİYES WPP

INSTALLED POWER: 78.6 MW TURBINE: 12 COMMISSIONING: 2022 MAIN EQUIPMENT: NORDEX LOCATION: KAYSERİ

Wind Power Plants 2023 Developments

We continued our wind energy investments in 2023 and reached a total installed power of 393 MWe/410 MWm in our 8 power plants, including the capacity increase of Erciyes WPP (13.6 MW), the generation initiation of Akköy WPP (25.2 MW) as well as the addition of both Dikili WPP (7.2 MW) and Çeşme WPP (18.9 MW) to our portfolio respectively.

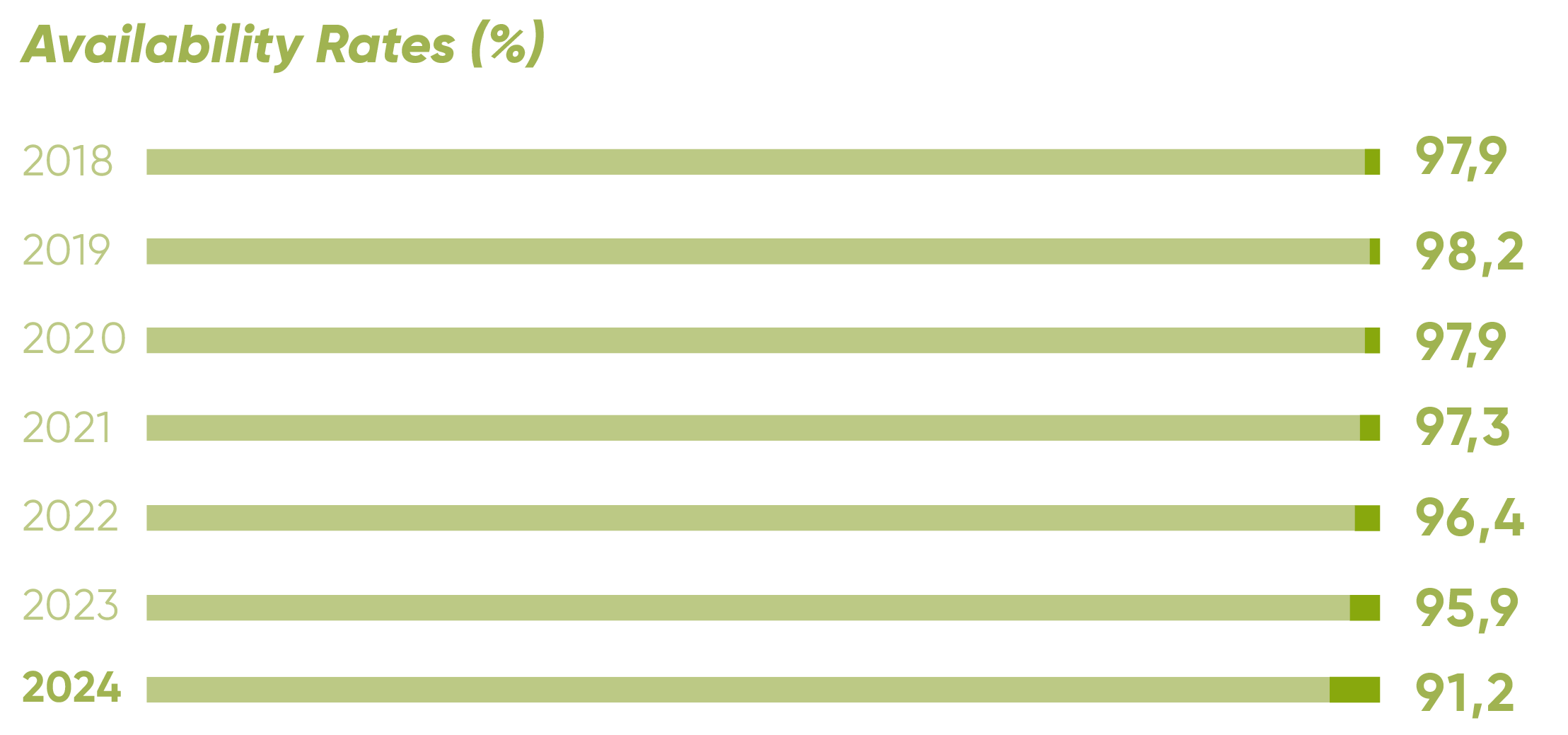

Availability Rates (%)

2018
97.9
2019
98.2
2020
97.9
2021
97.3
2022
96.4
2023
95.9

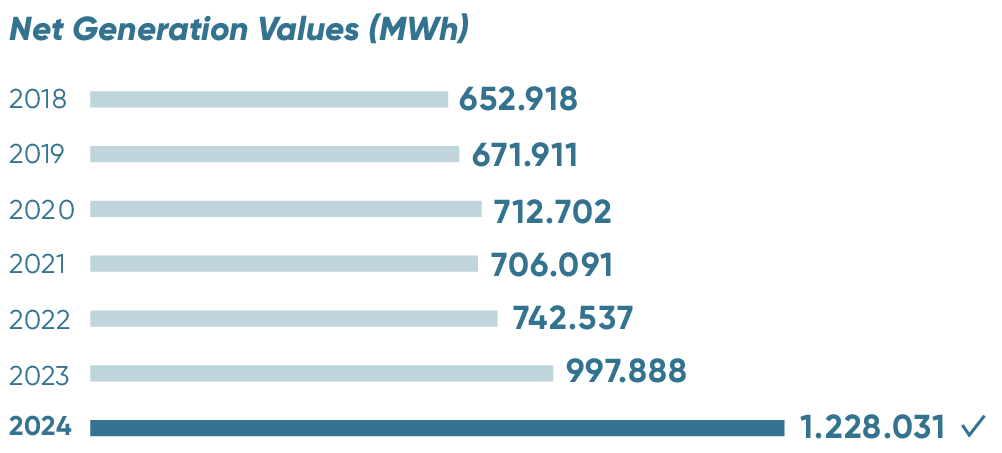

Net Generation Values (MWh)

2018
652,918
2019
671,911
2020
712,702
2021
706,091
2022
742,537
2023
997,888

Erciyes WPP Capacity Increase

At Enerjisa Üretim, we increased the licensed power of our power plant from 65 MW to 78.6 MW in line with our wind energy and solar energy investment targets, wherein our country holds a strong potential. Accordingly, we supplied, installed and commissioned 4 N167 5.9 MW Nordex turbines.

Akhisar WPP Capacity Increase

We completed the majority of our 7 MW additional capacity investment for Akhisar WPP in 2023 Accordingly, we finalised the foundation excavation, iron reinforcement and concrete casting of 1 N163 6X model turbine supplied. Currently, our installation and commissioning work continues.

We carry out all our wind power plant maintenance activities digitally.

Hybrid Solar Power Plants

BANDIRMA 2
HYBRID SPP

INSTALLED POWER: 11.9 MW COMMISSIONING: 2022 LOCATION: BALIKESİR

ÇANAKKALE
HYBRID SPP

INSTALLED POWER: 3 MW COMMISSIONING: 2022 LOCATION: ÇANAKKALE

TUFANBEYLİ
HYBRID SPP

INSTALLED POWER: 5.3 MW COMMISSIONING: 2022 LOCATION: ADANA

ERCİYES
HYBRID SPP

INSTALLED POWER: 14.5 MW COMMISSIONING: 2022 LOCATION: KAYSERİ

BARES
HYBRID SPP

INSTALLED POWER: 11.9 MW COMMISSIONING: 2023 LOCATION: BALIKESİR

BANDIRMA 1
HYBRID SPP

INSTALLED POWER: 6.5 MW COMMISSIONING: 2022 LOCATION: BALIKESİR

KENTSA
HYBRID SPP

INSTALLED POWER: 2 MW COMMISSIONING: 2023 LOCATION: KOCAELİ

Solar Power Plants

BANDIRMA GES

INSTALLED POWER: 2 MW COMMISSIONING: 2017 LOCATION: BALIKESİR

KARABÜK GES

INSTALLED POWER: 7 MW COMMISSIONING: 2017 LOCATION: KARABÜK

Unlicensed Solar Power Plants

We have a total of 2 solar power plants with an installed capacity of 9 MW in operation in Bandırma and Karabük.

Net Generation Values (MWh)

2018
14,474
2019
14,483
2020
14,747
2021
13,802
2022
13,593
2023
13,764

Our Hybrid Solar Energy Investments

Thanks to the steps we took in 2021 and 2022, we turned all our wind and thermal power plants into hybrid power plants with the addition of solar power plants. We plan to commission a total of at least 150 MW of licensed, unlicensed and hybrid solar power plants in 2024, including the 76 MW investments we had completed in 2022 and 2023 respectively.

Solar Power Plants 2023 Developments

Çanakkale Hybrid SPP Activities

We have continued preparations for the Çanakkale Hybrid SPP project with a targeted power of 5.9 MW. The field work for the 2nd stage has been largely completed and we continue with the pre-energization testing process.

Bandırma Unlicensed SPP Activities

We have left behind the 6th year of generation of our power plant and have completed all its respective periodic maintenance by our own team of 10 people/day, thus contributed to increasing its availability values. At the same time, we have carried out agrivoltaic studies in the power plant field and have created an exemplary area, showcasing that solar power plants and agricultural activities can be carried out simultaneously.

Bandırma Hybrid SPP Activities

We have completed the field work of the 6.5 MW Bandırma 1 Hybrid SPP and the 11.9 MW Bandırma 2 Hybrid SPP, receiving their approval from the Ministry. Moreover, within the borders of Bandırma Energy Base, we have increased our total installed solar power to 31.5 MW.

Bares Hybrid SPP Activities

We have completed the field work of the project with a capacity of 11.88 MW and moved on to its energization and Ministry approval phase.

Karabük Unlicensed SPP Activities

We have completed all periodic maintenance in a short period of time by our own team and contributed to increasing the availability values of the power plant. Predicting that the warranty period of inverters -which are one of the most essential equipment of the power plant- would expire, leading to an increase in age-related malfunctions, 2 of our technicians have accordingly completed the Inverter Repair Training provided by the inverter manufacturer.

Kentsa Hybrid SPP Activities

We have completed the field work of the 2 MW capacity project and moved on to the its energization and Ministry approval phase.

Erciyes Hybrid SPP Activities

As the continuation project of the 14.5 MW Hybrid SPP, we have largely completed the field work of the 9.3 MW SPP project in 2023 Our procedural formalities for energization and Ministry approval are on-going.

Tufanbeyli Hybrid SPP Activities

We have received the Ministry's acceptance of the 5.3 MW Hybrid Solar Power Plant in July 2023 and have largely completed the field work of the projects for the capacity increase of 12.3 MW and 1 MW respectively. Our punch completion, pre-energization tests and Ministry approval phase are still on-going.

Hydroelectric Power Plants

With our 12 power plants, we are the leading player that operates the most hydroelectric power plants within Türkiye's private sector, playing an important role as an assurance of our country's energy system. We have a total installed power of 1,353 MW with our power plants located in the Seyhan (6), Ceyhan (4) and Eastern Black Sea (2) basins.

Thanks to high availability and successful commercial operations, we had a productive year for our hydroelectric power plants, despite the drought as the year unfolded.

Seyhan Basin Adana

KAVŞAK BENDİ HEPP

INSTALLED POWER: 191 MW RESERVOIR SIZE: 30 hm3 COMMISSIONING: 2014 TURBINE TYPE: FRANCIS MAIN EQUIPMENT: ALSTOM

YAMANLI 2 HEPP

INSTALLED POWER: 82 MW RESERVOIR SIZE: 2 hm3 COMMISSIONING: 2015 TURBINE TYPE: FRANCIS MAIN EQUIPMENT: YUNHE

KÖPRÜ HEPP

INSTALLED POWER: 156 MW RESERVOIR SIZE: 93 hm3 COMMISSIONING: 2013 TURBINE TYPE: FRANCIS MAIN EQUIPMENT: ALSTOM

DOĞANÇAY HEPP

INSTALLED POWER: 62 MW RESERVOIR SIZE: REGÜLATÖR COMMISSIONING: 2017 TURBINE TYPE: KAPLAN MAIN EQUIPMENT: ORIENT

MENGE HEPP

INSTALLED POWER: 89 MW RESERVOIR SIZE: 51 hm3 COMMISSIONING: 2012 TURBINE TYPE: FRANCIS MAIN EQUIPMENT: ALSTOM

KUŞAKLI HEPP

INSTALLED POWER: 20 MW RESERVOIR SIZE: REGÜLATÖR COMMISSIONING: 2013 TURBINE TYPE: KAPLAN MAIN EQUIPMENT: ORIENT

Ceyhan Basin Kahramanmaraş

KANDİL BARAJI ve HEPP

INSTALLED POWER: 208 MW RESERVOIR SIZE: 439 hm3 COMMISSIONING: 2014 TURBINE TYPE: FRANCIS MAIN EQUIPMENT: ANDRITZ

SARIGÜZEL BARAJI ve HEPP

INSTALLED POWER: 102 MW RESERVOIR SIZE: 59 hm3 COMMISSIONING: 2013 TURBINE TYPE: FRANCIS MAIN EQUIPMENT: ANDRITZ

HACININOĞLU HEPP

INSTALLED POWER: 142 MW RESERVOIR SIZE: REGÜLATÖR COMMISSIONING: 2011 TURBINE TYPE: FRANCIS MAIN EQUIPMENT: ANDRITZ

DAĞDELEN HEPP

INSTALLED POWER: 8 MW RESERVOIR SIZE: REGÜLATÖR COMMISSIONING: 2013 TURBINE TYPE: KAPLAN MAIN EQUIPMENT: ORIENT

ARKUN BARAJI VE HEPP

INSTALLED POWER: 245 MW RESERVOIR SIZE: 283 hm3 COMMISSIONING: 2014 TURBINE TYPE: FRANCIS MAIN EQUIPMENT: ALSTOM

ÇAMBAŞI HEPP

INSTALLED POWER: 44 MW RESERVOIR SIZE: REGÜLATÖR COMMISSIONING: 2013 TURBINE TYPE: PELTON MAIN EQUIPMENT: VOITH

Hydroelectric Power Plants 2023 Developments

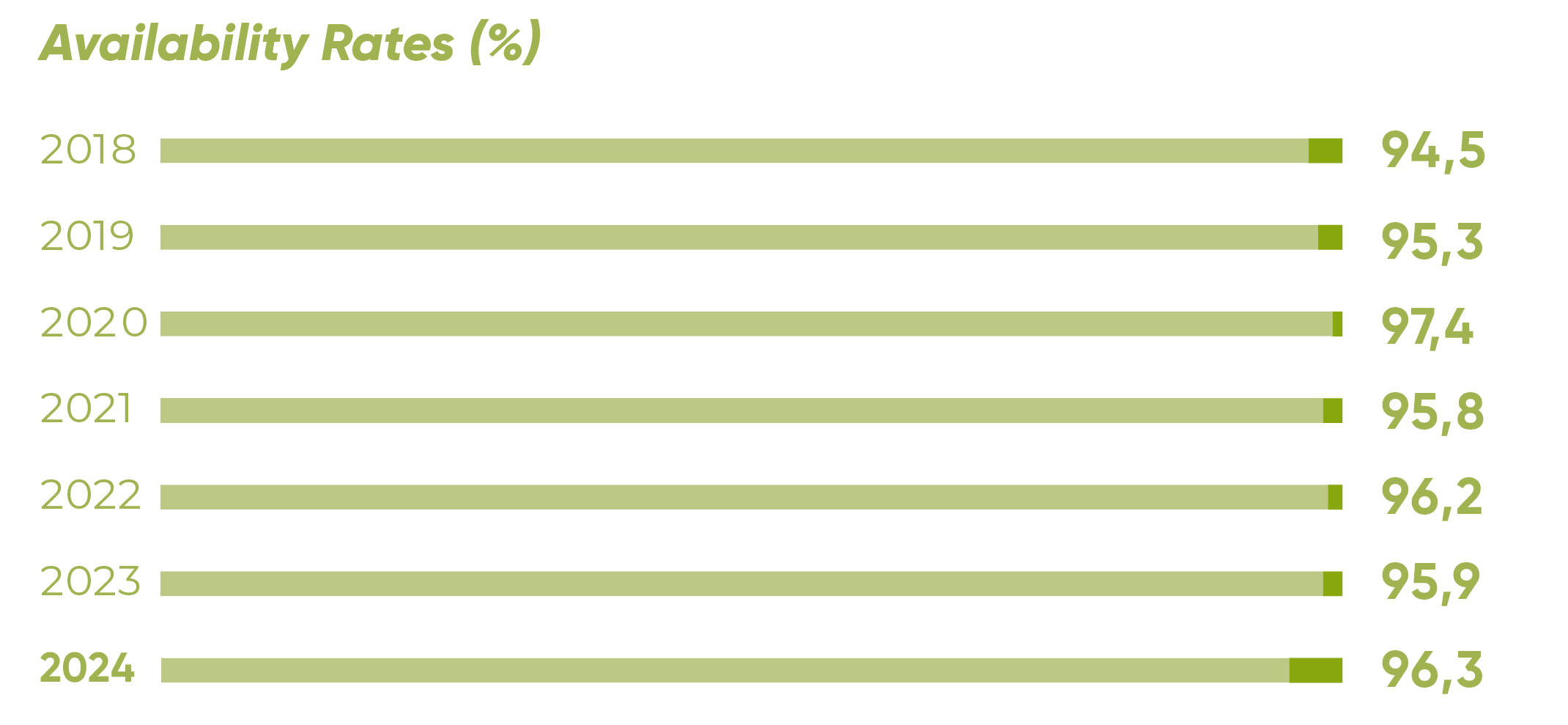

Availability Rates (&)

2018
94.5
2019
95.3
2020
97.4
2021
95.8
2022
96.2
2023
95.9

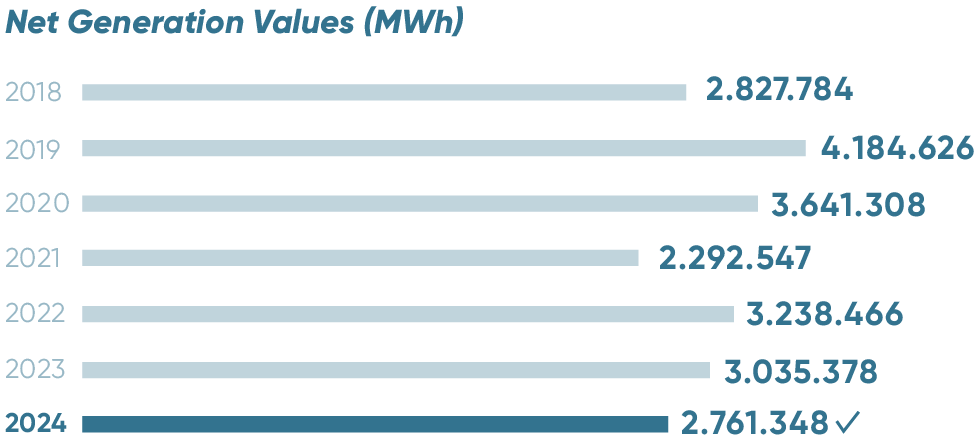

Net Generation Values (MWh)

2018
2,827,784
2019
4,184,626
2020
3,641,308
2021
2,292,547
2022
3,238,466
2023
3,035,378
  • We have completed the infrastructure installation of the charging stations with 22 kVA AC power in all our hydroelectric power plants, in line with our goal of becoming carbon net-zero by 2045 by tapping into our renewable energy resources.
  • We have managed both planned and unplanned maintenance activities for our 12 hydroelectric power plants, with an average age of 11, through artificial intelligence- based criticality analysis studies. In this way, our unplanned downtime rate (EFOR) was realised as 0.17% and our planned downtime rate (EPOR) as 3.42% in the last 4 years. We have successfully carried out our 5-year maintenance in all our power plants, which played a major role in achieving this performance, and our 10-year maintenance in all our power plants which over 10 years old. Thanks to our maintenance performance culture, we strengthen our commitment to safely providing the energy that Türkiye needs.
  • By combining the renovation work and wheel replacement we carried out in accordance with OHS standards at our Yamanlı 2 Hydroelectric Power Plant with environmentally friendly practices, we maximized operational excellence and strengthened our sustainable energy vision.
  • We implemented the governor system upgrade work carried out in our Dağdelen and Kuşaklı Hydroelectric Power Plants, together with the rehabilitation and renewal of the system, all with the aim of increasing technological innovation and availability. With this update that reduces malfunctions, we have taken a step in line with our aim of carrying our vision forward by contributing to the construction of a more reliable and effective system in energy generation.
  • By installing Mini WPP (1.5kW) and Solar Power Plant (2.2kW) on the Hacınınoğlu HEPP regulator, we fed 5 lighting fixtures in the regulator and developed a project within the scope of ISO50001.
  • We used the water resources of each of our hydroelectric power plants efficiently by utilizing optimization activities in the most effective way.
  • By incorporating new technologies emerging in the energy ecosystem into our own system, we have implemented projects that make data meaningful with advanced analytical methods, generate realistic predictions and support strategic decisions.
  • We carried out reservoir management and optimization studies with precipitation and temperature data obtained from leading meteorological forecast sources such as ECMWF and GFS. These data also served as an early warning system against meteorological and hydrological risks.
  • We also optimized our real-time power plant operations by using snow cover, soil moisture and snow-water equivalent data obtained from satellite images for flow forecasting with the Delft FEWS model and internal development optimization algorithms.

Examples of Our Other R&D Studies

  • In line with our vision for carrying out maintenance works such as integration of innovative technologies, adoption of cost-reducing strategies, implementation of innovative approaches in maintenance and placing innovation at the centre, we examined the emergency valve at Sarıgüzel HEPP with an underwater robot. In this way, we contributed to Sarıgüzel HEPP's operation in a more reliable, effective and sustainable manner.
  • By turning Hacınınoğlu HEPP into a Dark Plant, we made it monitorable from the centre via the radar and high-level camera systems, thus increasing the security of the plant.
    The Dark Plant initiative we carried out in our hydroelectric power plants was the out-put of a vision shaped by foresightedness and innovation, which enabled us to emphasize our determination for a sustainable future thanks to the man/hour savings we achieved in terms of energy efficiency and business continuity.
  • Thanks to raising the SFC capacity in our hydroelectric power plants, we supported sustainability in energy generation worldwide and managed to use clean energy resources more effectively. By increasing the SFC capacities at Arkun, Köprü, Menge and Kavşakbendi HEPPs, we achieved a 44 MW reserve increase as a result of all SFC renewal and capacity increase tests. In this way, we achieved an annual earnings increase of roughly 220 million TRY.

Maintenance Management Strategy

We have gone beyond the traditional maintenance approach to ensure that our power plants continue to operate at the desired performance level.

In this context;

  • In accordance with our new maintenance management strategy, we received the necessary training in transition to TPM (Total Productive Maintenance) methodology. We started our work by creating planned maintenance, autonomous maintenance, training, kaizen and OHS committees.
  • We determined fixed KPIs in order to regularly monitor maintenance metrics according to the EN 15341 maintenance KPI standard.
  • Within the scope of the KOZA Project, we completed the infrastructure work at our Doğançay and Hacınınoğlu power plants. While continuing our tests, we also carry on with operations at our other power plants.
  • As a result of the studies carried out, we reached an availability rate of 95.9%.

ENERGY BASES

Türkiye's Premier and Pioneering Energy Hub: Bandırma Energy Base

Bandırma Energy Base is at the heart of Türkiye's energy supply security, not only with its efficiency but also its strategic location. Thanks to its connection to the western lines, where electricity consumption is the highest, our energy base plays an indispensable role in the electricity generation with its high efficiency and available capacity always at hand, in critical periods when restrictions are felt in the electricity network.

Our Bandırma 1 and Bandırma 2 natural gas power plants become a permanent shield of network security by closing potential gaps in energy supply within minutes with our ability to intervene in the instantaneous transmission system.

Bandırma Energy Base, built on a large area of approximately 204 hectares, is really quite an energy centre with its impressive coastline of 650 metres and a depth of 3,700 metres. The structure, which rises to 189 metres above sea level, holds strategic importance in Türkiye's energy future.

The Most Beautiful Power Plant in the World

  • 2 natural gas power plants that are Türkiye's most efficient, serving grid security
  • 1 integrated hydroelectric power plant that meets the internal needs of the power plant
  • 3 hybrid solar power projects, 1 of which is agrivoltaic
  • 3 wind turbine projects
  • Türkiye's first green hydrogen valley*

*We started the pilot hydrogen generation.

1,543
Total Power (MW)

BANDIRMA 1 NATURAL GAS CYCLE POWER PLANT

INSTALLED POWER: 936 MW AVERAGE NET EFFICIENCY: 59% COMMISSIONING: 2010 MAIN EQUIPMENT: MITSUBISHI

BANDIRMA 2 NATURAL GAS CYCLE POWER PLANT

INSTALLED POWER: 607 MW AVERAGE NET EFFICIENCY: 60% COMMISSIONING: 2016 MAIN EQUIPMENT: SIEMENS

3 SOLAR POWER PLANTS, 1 of which is AGRIVOLTAIC

INSTALLED POWER: 29.4 MW COMMISSIONING: 2022 & 2023

1 HYBRID HYDROELECTRIC ENERGY PLANT

INSTALLED POWER: 3.5 MW COMMISSIONING: 2014

1 HYDROGEN GENERATION FACILITY

INSTALLED POWER: 2 Nm3/h COMMISSIONING: 2022

Bandırma Energy Base 2023 Developments

Bandırma Energy Base generates electricity with 5 different innovative energy generation methods, including ground-breaking technologies such as battery storage and hydrogen generation. Our base positions itself as an innovation and R&D centre by closely following the latest technological developments in the sector and hosting various innovative projects. We act with the vision of being a platform that shapes the transformation in the energy sector by collaborating with Bandırma Energy Base and initiatives that aim to lead the sustainable future.

We played a successful role in meeting Türkiye's energy supply security throughout the year thanks to the successful day-ahead and intra-day planning of our natural gas power plants.

Bandırma Energy Base: A Nexus of Innovation, R&D and Start-Up Centre

Bandırma Energy Base Transformation Plan, which we will implement gradually

Click to watch the video

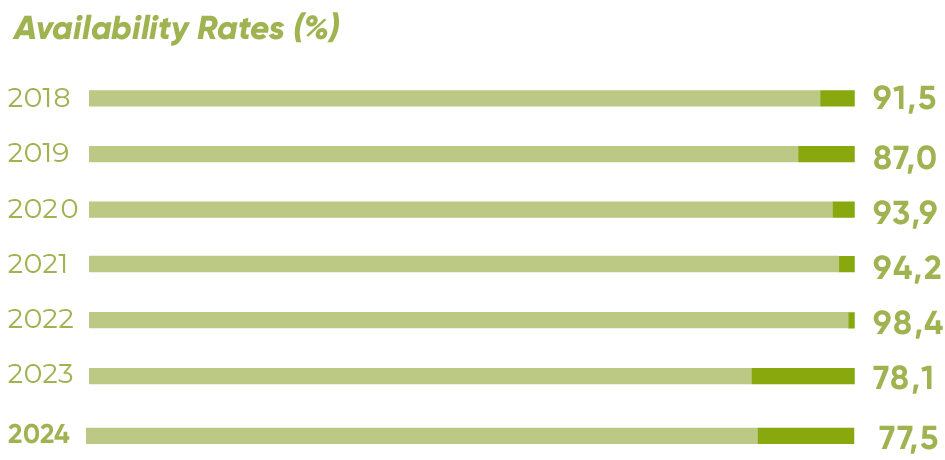

Availability Rates (&)

2018
91.5
2019
87.0
2020
93.9
2021
94.1
2022
98.4
2023
78.0

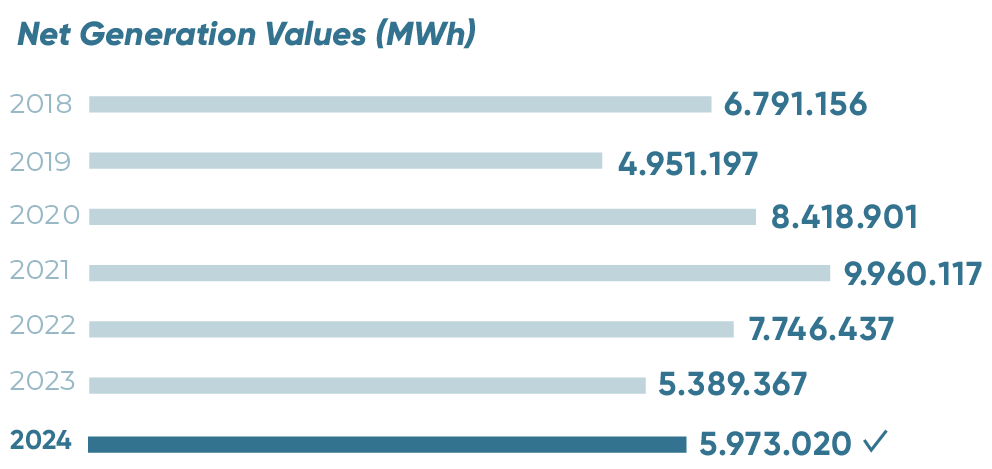

Net Generation Values (MW)

2018
6,791,156
2019
4,951,197
2020
8,418,901
2021
9,960,117
2022
7,746,437
2023
5,389,367

Enercon-Enerjisa Generation Bandırma Energy Base Co-operation

We are breaking new ground in Türkiye with the co-operation of Enercon at Bandırma Energy Base. We carried out R&D studies and field feasibility studies for the installation of the E-175 EP5 model turbine, which has the largest rotor diametre in the world, ranging up to 175 metres, 6 MW power and expandable capacity.

Hydrogen Valley Developments with the European Union

We are putting into implementation Türkiye's first Hydrogen Valley thanks to the European Union (EU) project with a budget of 36.8 million euros, coordinated by the Southern Marmara Development Agency, involving Enerjisa Üretim and Sabancı University and 16 local and foreign stakeholders. Within the scope of the "South Marmara Hydrogen Coast" Valley Project, we are establishing Türkiye's first green hydrogen facility at our Bandırma Energy Base with a minimum of 500 tonnes of green hydrogen per year.

Meeting Hydrogen Consumption with In-Plant Generation

In 2023, we met 42% of the hydrogen consumption used for the cooling of Bandırma 2 generator, thank to our hydrogen generation electrolyser.

Process Safety

Within the scope of process safety, we conducted a HAZOP study on the hydrogen electrolyser unit with 3rd party companies and took actions to increase safety in line with the reports.

Domestic Electrolyser

Following the approval of the Ministry of Industry for the development of domestic electrolysers within the scope of Guided Project Support, we kick-started our own electrolyser project officially. The first meeting was held at Bandırma Energy Base, hosted by us, and with the participation of TUBITAK MAM (Turkish Scientific and Technological Research Council Marmara Research Centre), Eti Maden and GMKA (Southern Marmara Development Agency) respectively. Feasibility studies for green hydrogen and green ammonia generation were completed with international consultancy companies.

Energy Efficiency Studies (Energy Audit)

Due to today's competitive conditions and increasing energy prices, we have initiated studies that will enable any business to use the energy it consumes effectively, update its technology by making timely investments, saving money by minimizing possible losses in its process thanks to the optimization and continuous control of its operating conditions, and increase its energy efficiency. Within the scope of energy efficiency, we investigated the effect of hydrogen purity on the generator output power in Bandırma 2 power plant. As a result of correspondence with the manufacturer and theoretical calculations, we saw that when the purity was increased from 96.5% to 97.5% in the first stage, the generator output power increased by 78 kW. By increasing hydrogen purity within the scope of energy efficiency, we estimate that 1,700,000 TRY will be saved when operating at 70% annual capacity.

Hybrid SPP Works

We have completed the 18.4 MW Bandırma 1 and Bandırma 2 hybrid solar projects approved by the Ministry, which we commissioned back in 2022, and the 11 MW Bandırma 1 3rd stage work, which we energized in 2023.

Maintenance

We went through a comprehensive transformation process with planned and unplanned maintenance during the year for our Bandırma 1 and 2 natural gas power plants, which are the flagships of the Turkish grid thanks to their high efficiency and flexibility. In this way, our Bandırma power plants will continue to be the assurance of the network for the next 3 years.

Administrative Building Carbon Zero Project Pomega – Eco-Friendly Building

Within the framework of the plans we initiated regarding the 'Eco-Friendly Building' project, we aim to meet the energy needs of the Bandırma 1 administrative building with solar and wind energy. We will store this energy through solar, wind and solar panels located in 2 Pomega hybrid containers to be installed on the building roof. Thanks to the transfer of stored energy, we will provide the lighting, ventilation, heating and other energy requirements of the aforementioned Bandırma 1 administrative building.

We plan to implement a green and living wall along the facade of the building with a soil-free vertical garden application. We will provide some of the water required for these plants with rainwater collected on the building roof.

The systems we will install will be controlled by BMS, and our energy generation, consumption and water use will be constantly monitored through the energy monitoring system. Thanks to our project, we aim to reduce carbon emissions to zero as well as increasing energy efficiency. We plan to put the Carbon Zero project, which has an installed power of 90 kW, into operation in June 2024.

Battery

In order to increase the power and sustainability of renewable energy, we will establish an energy storage system using LFP batteries with lithium-ion technology, in accordance with the criteria required by TEİAŞ (Turkish Electricity Transmission Corporation), such as arbitrage and peak shaving. In the Bandırma 2 Power Plant, the 2 MW/4 MWH 0.5 C-Rate battery energy storage unit, integrated with the 5 MW SPP and connected to the natural gas power plant MV bus, will be able to discharge the stored energy to the grid at times when commercial conditions are suitable. We plan to commission our project, the first steps of which we took during the year, in July 2024.

Charging Track

We have initiated studies on a smart, environmentally friendly and sustainable mobility track for electric vehicles. Within a distance of 100 metres, vehicles will be able to charge while in motion by inductive transmission of electrical cables. Vehicles will be able to benefit from static electricity while parked. We are at the technical specification stage during the course of our co-operation with Electreon company.

Agrivoltaic

We had our first harvest at Bandırma Energy Base on October 21st in our Agrivoltaic application, which we had started with Komşuköy.

Click to watch the video

As part of our efforts to increase the efficiency of our workflows, we switched to the Dynamics 365 Asset Management module, which has a user-friendly interface. During the architectural phase of the project, we examined all the projects from the installation of Bandırma 1 and 2 power plants until today and added the records of the equipment used in the field to the inventory list.

Türkiye's First Lignite to Renewable Energy Conversion Hub: Tufanbeyli Energy Base

Our Tufanbeyli Energy Base is preparing to write a success story as a global good practice example for the green energy transition. We plan to gradually transform the lignite power plant into a low-emission energy generation facility by 2045, without compromising our energy supply security.

The current integration of our power plant into the electricity grid -enabling us to reach a minimum of 300 MW solar energy installed power over the years with both our completed and ongoing Hybrid Solar Energy projects- reveals the fact that it can play a critical role not only in increasing the speed of renewable energy projects but also pave the way for the integration of such projects.

With our green transformation initiatives that we initiated with solar energy installations, we aim to incorporate various innovative technologies over time. Tufanbeyli has the potential to become a data processing and energy storage centre.

Our project approach adopts a just transition model that will transform not only our energy generation methods but also our social welfare. With this project, which will set an example for the whole world, we aim to take the necessary measures to ensure that the burden of the changes does not fall disproportionately on those who will be most affected, and that this transition is socially fair with planned actions.

We will position our learning centre, the Academy, as a talent development centre that will play a key role in this transformation process, supporting employees' adaptation to the renewable energy sector. Our work offers the potential to lead the industry in expanding talent and knowledge as we accelerate the pace of the renewable energy transition.

All these factors make our energy generation base a prominent and exemplary model within the scope pf global just transition practices.

TUFANBEYLİ

INSTALLED POWER: 450 MW COMMISSIONING: 2016 MAIN EQUIPMENT: SIEMENS

Tufanbeyli Energy Base 2023 Developments

In 2023, we received the reward of our long-term investments in the name of operational excellence as well as the disciplines we laid the foundations of years ago in terms of both mine and power plant operations. In this context, as a result of our high availability, efficient operation and optimization activities -in particular, thanks to our successful maintenance planning- we broke the one-year total generation record in 2022 and generated 3.43 TWh of energy in 2023.

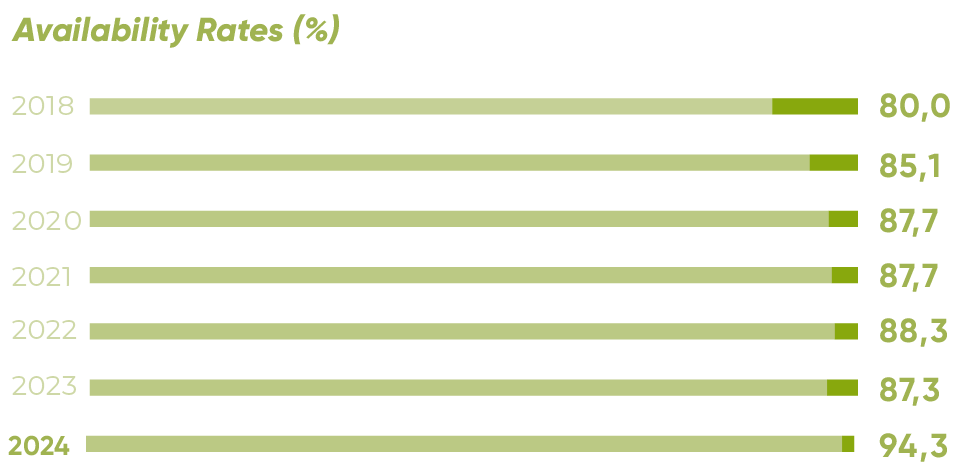

Availability Rates (%)

2018
80.0
2019
85.1
2020
87.7
2021
87.8
2022
88.2
2023
87.3

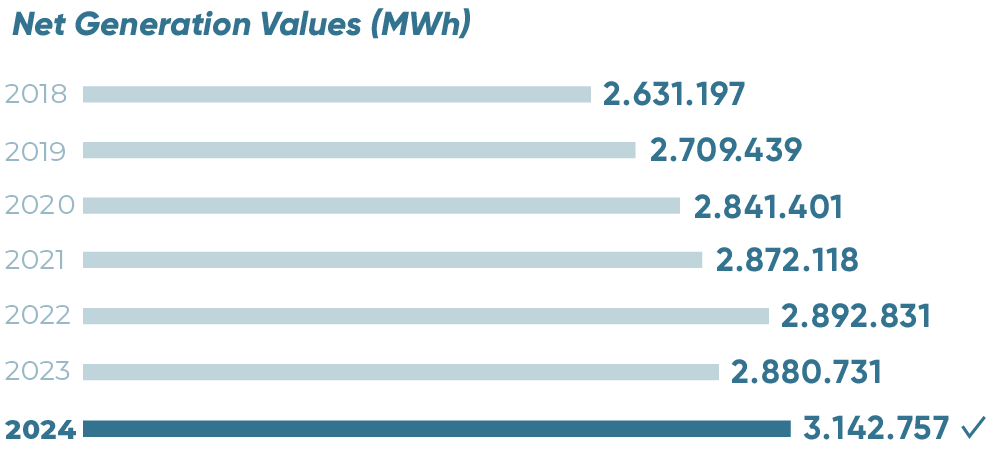

Net Generation Values (MWh)

2018
2,631,197
2019
2,708,438
2020
2,841,401
2021
2,872,118
2022
2,912,936
2023
2,905,439
  • We established a 13.6 MW hybrid solar project within the scope of our renewable energy investments.
  • In 2023, domestic consumption rates decreased by %5 thanks to the installation of solar power plants and projects to reduce domestic needs.
  • When there is a problem in the transmission lines feeding the Tufanbeyli district in harsh winter conditions or when work is done on these lines, the district's electricity needs can be met from our Tufanbeyli power plant, as a matter of social responsibility. In this sense, we supplied 5,771 MWh of energy for the district in 2023.

Kentsa

While we continue to provide electricity transmission to factories with our natural gas power plant, Kentsa, with an installed capacity of 40 MW in Kocaeli, we also support the power plant with our hybrid solar investments with an installed power of 2 MW, which we commissioned in 2023.

INSTALLED POWER: 450 MW - COMMISSIONING: 2016 - MAIN EQUIPMENT: SIEMENS

SENKRON Central Control Room

With Enerjisa Üretim Central Operation Control, Monitoring and Development Operation SENKRON, we organize the remote operation, performance and status monitoring processes of our power plants.

Our Senkron Performance Monitoring and Development team provides 24/7 performance and status monitoring services for a portfolio of approximately 4 GW capacity of internal and external customers in 5 different technologies. The team provides services in real-time monitoring of power plants, investigating alarm situations and preparing monthly evaluation reports.

In 2023, we commissioned Dikili, Çeşme and Akköy WPP in full compliance with SENKRON infrastructure and processes besides starting remote operation and performance monitoring activities. We also monitor our 55 MW capacity hybrid SPP in this context.

We started the joint SCADA project in order to simplify the increasing number of power plants and processes and improve the systems accordingly. In line with the project, we plan to operate the power plants according to the instantaneous target load demands without requiring any operator intervention. We aim to complete the project and put it into operation in 2024 Moreover, we developed digital twins with 126 machine learning models using a total of 409 features for instant performance and status monitoring alarms as well as early detection of faults. The models we have created make predictions at 10-minute intervals and carry out monthly analyses by comparing them with real values.

We have started using Onepact and its AIPact modules -developed by Senkron Energy Digital Services- when providing services to both internal and external power plants, which enables us to manage different technologies in various locations via a single IT platform.

In addition to its technical competencies, Senkron Operation and Control Room also draws attention with its personnel competency programmes. The adaptation journey of our current field employees to digital infrastructures, which we had developed for SENKRON, was discussed in all its aspects during the two-day visit of Harvard Business School Professor Prithwiraj Choudhury and his team. As a result of these reviews, our programme was selected as a “Case Study” by Harvard Business School.

TECHNICAL RISK MANAGEMENT

With Technical Risk Management, we aim to identify and eliminate risks that may harm people and the environment, create legal non-compliance and reduce the availability of power plants, as well as identify and realize opportunities that can create value. In this respect, we evaluate the effects of technical risks and opportunities in the fields of OHS, environment, reputation and finance. Risk identification consists of two main processes, namely internal and external. Internal audit processes are planned and carried out by our functions for methodical and systematic risk detection. In this context, respective hazard detection methods (HAZOP, FMEA, etc.), recommended at international standards in all locations, are implemented by experts with different specialities such as the manufacturer's expert, risk analysis expert, etc. based on the technical need. Externally managed risk detection processes include credit provider reviews, insurance audits, internal audit process and ISO management systems.

We carried out risk assessment studies using Bow-tie analysis for the solar power plants planned to be established in various fields within the scope of the combined electricity generation facility. We classified the developments that may be encountered throughout the process into 38 categories in 12 separate sub-processes. In a workshop where legal issues, project management and technical issues were examined in detail, we put forward a documentation and operational system that may serve as a guidance for the hybrid power plant projects in which we are closely interested.

PURCHASING

We carry out our purchasing activities in line with company goals and sustainability principles with a responsible supply chain approach. Creating long-term strategic relationships with our suppliers, we establish our collaborations with the principle of winning together.

A PURCHASING APPROACH FOCUSED ON GOALS AND SUSTAINABILITY

Sustainable Supply Chain Management

1,458
Suppliers
15,287
Total Orders
22.9 Billion TRY
Total Orders Worth
600 Million TRY
Domestic Orders Amounting to
